If you work in the construction industry, you will most likely have heard of the Construction Industry Research and Information Association or CIRIA.
They are an independent, not-for-profit body at the forefront of the construction industry. Their work addresses industry issues, challenges and opportunities to provide business and delivery improvement.
One unintended outcome from construction activity is that items of Unexploded Ordnance (UXO) are occasionally discovered. When it is, it usually generates considerable media interest and can cause major disruption to the public.
Fortunately, experience shows that the number of casualties resulting from UXO encounter in the UK is low. However, as it is a low probability but high consequence event, appropriate allowance should be made at the design stage for assessing the risk of encountering UXO and for mitigating that risk.
This is where CIRIA C681 comes in to play, with an industry guide for the management of risk associated with UXO.
In the UK, surprisingly there is no specific legislation that requires the construction industry to undertake UXO risk mitigation measures before construction or development work begins.
However, clients do have a legal obligation under CDM2015 to provide specific health and safety information needed to identify hazards and risks associated with design and construction work.
Under the Health and Safety at Work Act 1974 every employer must ensure the health and safety of their employees and that of other persons who are affected by their work activity.
Therefore, pre-planning and accessing your site for UXO risk before development works commence is essential to mitigate any potential safety risks.
For more information about the risk management process, including best practices, case studies and a detailed guide to UXO risk in the UK – it is recommended that the 2009 document ‘C681 Unexploded Ordnance (UXO) A Guide for the Construction Industry‘ is read and understood.
The principal purpose of this document is to provide the UK construction industry with a set and defined process for the management of risks associated with UXO from WWI and WWII aerial bombardment, and current / historic military activity.
It focuses on the needs of the construction professional if there is a suspected UXO discovery on-site and covers issues such as what to expect from an UXO specialist. 1st Line Defence conform to the recommendations set out in this guide, and our management team were part of the original steering group for this document.
CIRIA C681 was updated in 2019 by a more concise version of the original document – ‘Unexploded ordnance (UXO) risk management guide for land-based projects (C785)‘. The document was part authored by Phil Baptie, Director of Research at 1st Line Defence, and acts as a shorter more accessible handbook for the management of UXO risk on UK construction projects.
CIRIA have outlined a four-stage risk management process for constructors to follow, click on the following link to download an overview of the UXO Risk Mitigation Strategy we adhere to – in accordance with C681 Guidelines.
The four stages of CIRIA C681 are:
1. Preliminary UXO Risk Assessment
2. Detailed UXO Risk Assessment
3. UXO Risk Management
4. UXO Support / Implementation

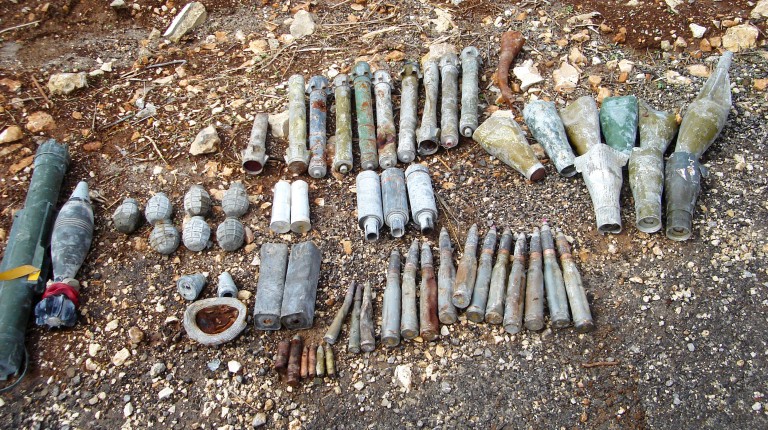

This UXO guidance is focused on WWI and WWII aerial bombardment, though it’s broadly applicable to other variants of UXO.

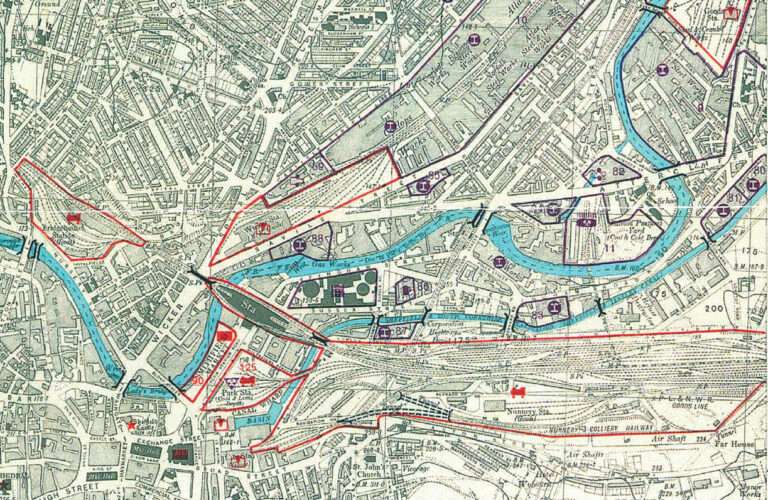

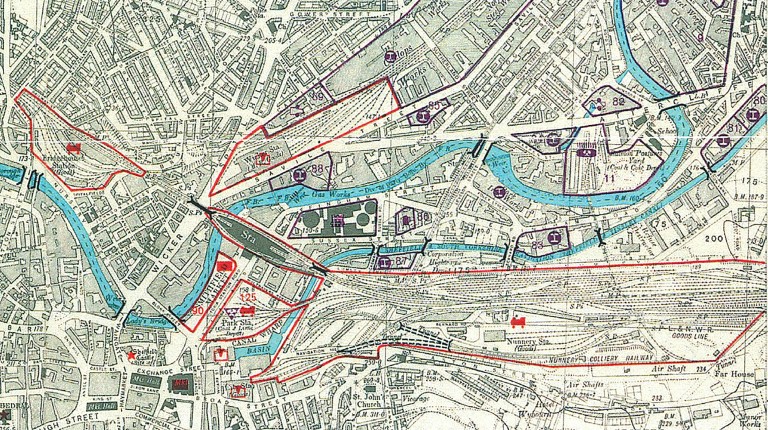

The Preliminary UXO Risk Assessment will investigate any military activity on or near your site to calculate the likelihood of you encountering UXO, it will include a risk rating and any recommended further actions.
We utilise internal and external resources and will deliver an accurate assessment within 24-48 hours from your order, allowing your project to proceed smoothly and safely.
If you require multiple Preliminary UXO Risk Assessments, contact us directly to check whether any discounts are available.

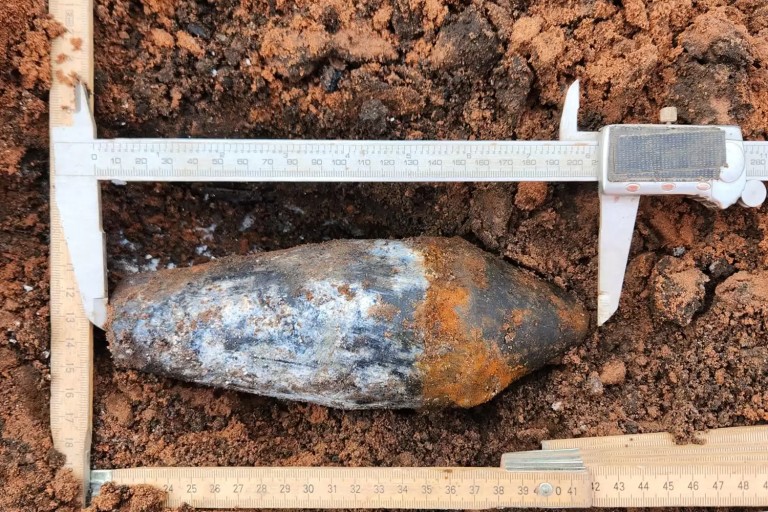

If any risk or need for further research is identified during the Preliminary UXO Risk Assessment, we would recommend that a Detailed UXO Risk Assessment is commissioned – which is a comprehensive and in-depth desktop study report which fully examines the history of a project.

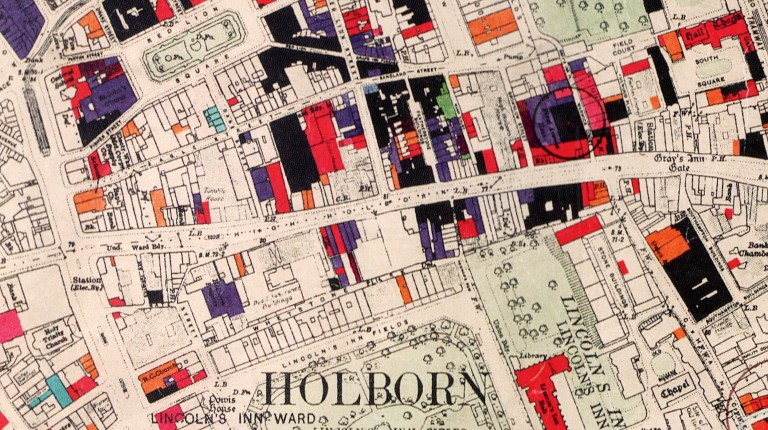

This detailed report includes specialist analysis of historical records including bombing maps, previous military use, location history and land use, reports and records of air-delivered bombs, frequency of access, consideration of any mitigating factors plus the extent and nature of proposed construction plans.
If the level of risk is ‘low’, no further action will be required unless future changes are proposed, for example – if deeper foundations and excavation of the site is required at a later date. However, if the risk rating is ‘medium’ or ‘high’, further investigation and action will be required.
Please note: If your site is located on a former military site, you will need to start the UXO risk mitigation process with this type of assessment.
If the level of risk on your site has been identified as ‘medium’ or ‘high’, we will provide a UXO risk management plan detailing the services required to address the risk.
If the risk mitigation solution proposed isn’t suitable, you may be required to review development plans, however – in the majority of cases we will be able to identify a suitable solution.

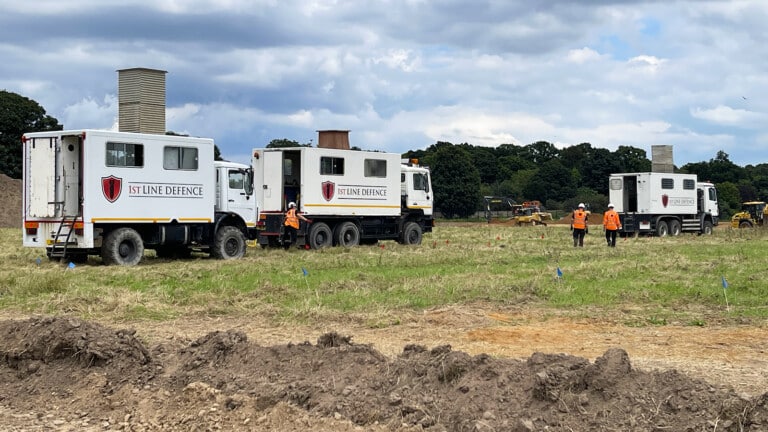

Once the risk mitigation solution has been approved, we will deploy UXO specialists to investigate your project – this could involve a Non-intrusive UXO Survey, with drones, carts or towed-array systems used to detect for ferrous metals without breaking ground. Alternatively, we might deploy one of our Intrusive UXO Survey rigs to site, which allows us to clear piles up to 25m beneath the ground and model targets in three dimensions in real-time.

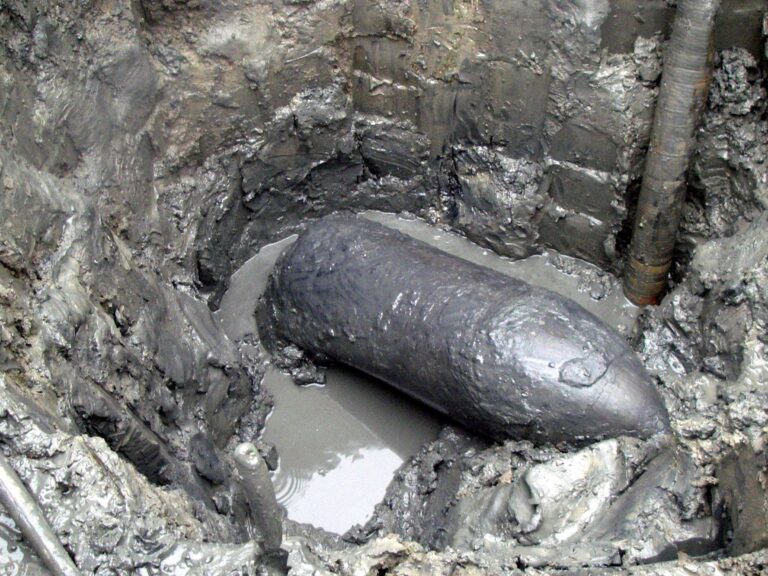

If an item of UXO is encountered, we will need to conduct a thorough investigation process and if necessary – amend the risk management plan. If no UXO is encountered during this stage you will receive a verification report stating that the risk has been reduced to as low as reasonably practicable (ALARP), and no further action will be required.
